FYP1 REPORT - TEMPERATURE AND HUMIDITY MONITORING SYSTEM FOR IMAGING ROOM VIA LORA TECHNOLOGY
Monday, November 16, 2020
WEEK 17
WEEK 15 AND WEEK 16
For this week, the draft report for chapter 1, chapter 2 and chapter 3 was send to the supervisor. It was to check if the format used is correct and the content in the report is fulfil the research needed.
Sunday, November 15, 2020
WEEK 14
For this week, the student is giving a time to finish up the proposal report to submit to their FYP supervisor. The flowchart for the project simulation has been created to show how the project work.
The flowchart show how the project simulation work. First, the sensor will detect the temperature and humidity in the imaging room and send the reading to the microcontroller. Then, Arduino uno will process the data. After the data has been process, it will send the data to the LoRa modules and the LoRa modules will transmit the data in the data log in system for the biomedical personnel to monitor the temperature and humidity reading in the imaging room.
Thursday, November 12, 2020
WEEK 13
WEEK 12
The assessor for the day were Ts. Madam Sabrina, Dr. Zuber and Mr. Kamil from Radibems. The presentation has been held for about 30 minutes. The question that has been asked during the presentation was 'what is the standard reading for the temperature and humidity for the imaging room?'. The answer would be 15% - 75% for the humidity while for the temperature, it is between 15 degree celcius - 28 degree celcius. Since the data collected by the Radibems is once for every two weeks, Dr.Zuber had suggest to coolect the reading everyday and every one hour, to have the data more precisely. Madam Sabrina asked to do more research on where the exact place in the imaging room that is suitable for the project to be place to do the simulation; either near the imaging equipment or far from the imaging equipment. Madam Sabrina also suggest to read more and do more research about the suitable sensor that will be used in the project, based on the previous work in the journal and technical paper. Madam Sabrina suggest to purchase the devices needed more early, so that the project can be simulate and know the exactly the connection for the devices. It is also good to do the project early, so that it will know how many power that will be used in this project simulation. Dr.Zuber had asked 'why it is necessary to monitor the temperature and humidity in the imaging room?'. The answer is to make sure the imaging equipment is in good condition because if the temperature and humidity reading is lower or exceed the standard range, it will probably make the imaging equipment malfunction.
WEEK 11
WEEK 10
WEEK 9

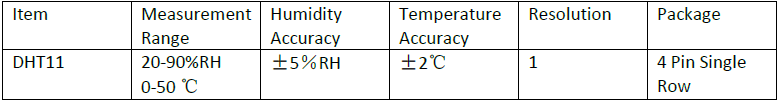

For this week, the research continue to find the suitable sensor that will be used in this project. The sensor that will be used in this project is DHT11 because it can detect both of the reading that is neede in this project, which are temperature and humidity. Below is the specification of the DHT11:
The measurement range for the temperature is between 0 until 50 degree celcius, with the temperature accuracy is about 2 degree celcius RH. That means the temperature reading by the DHT11 might be difference in about 2 degree celcius from the actual temperature in the room. The measurement range for the humidity is between 20% until 90% with 5% RH, that means the humidity reading in the room, might be slightly difference in about 5% from the actual temperature room. Both of the measurement range show that, it is the suitable temperature and humidity range that is needed in this project.
WEEK 8
For this week, the LoRa modules, SX1278 is purchased at shopee. The specification of the LoRa is been studied more, to determined either it is the suitable radio transmitter that will be used in this project. Below is the specification of the LoRa modules:
Supply voltage = 3.3 V
Temperature = 25° C
fXOSC = 32 MHz
bandwidth (BW) = 125 kHz
Spreading Factor (SF) = 12
Error Correction Code (EC) = 4/6
Packet Error Rate (PER)= 1%
CRC on payload enabled
Output power = 13 dBm in transmission
Payload length = 64 bytes
Preamble Length = 12 symbols
By seeing and study the above specification, it can be conclude that, this LoRa module is suitable to be used in this project.
Thursday, November 5, 2020
WEEK 7
WEEK 6
Tuesday, November 3, 2020
WEEK 5
WEEK 4
For the fourth week, Dr. Hasmiza has been agreed to be the supervisor for FYP. The first meeting was been held at her office, to discuss about the FYP title research. She suggested to do the project that have engage with the industry. The company that she suggest was Radibems, the company that providing non-clinical hospital support services. The title that been given was 'Temperature and Humidity Monitoring System For Imaging Room Via LoRa Technology'. She has asked to do the research about the temperature and humidity monitoring in the industries and also do more reading related to Lora technology. She also told that, Mr.Kamil, the technical manager from the Radibems, will be the second supervisor to lead about the project.
WEEK 3
For the third week, it has been scheduled that the student who takes FYP 1 will have to attend the briefing related to 'Introduction To FYP 1'. It was compulsory to the students to join the briefing to make sure that they will not miss any important information that will be delivered by FYP coordinator, Dr. Zuhanis. In the briefing, she told the student about what student will have to do during FYP 1. She also told the student about the important dates for the student to take note so that they will miss nothing in the future.
WEEK 2
For the second week, the students were still in the progress in finding the supervisor that will guide for FYP1. Not only that, some research has been done about the project that will be propose for FYP1. But unfortunately, the project that will be propose have few limitations that is quite difficult to overcome, for example, the cost to do the project is too expensive and the devices that will be used is some will only available in other countries, which is difficult when to do the purchasing for second or third time if the devices is broken in the future.
WEEK 1
For the first week, the student had been instructed by the FYP coordinator to find their supervisor and also the title for their project for FYP 1. The students that take the courses of BET Medical Electronic, has been encouraged to do the project related to the medical field. It will not only give the benefit from the knowledge of the study, but the project will also give the benefit to medical field and will contribute it advantages to others.
WEEK 17
For this week, the student need to submit the full report that has been amend, the plagiarism report and the link for the blog to their supe...
